Saturday, June 7, 2008

Doors & Windows

The door & window frames arrived in early June.



The front door was installed on 8th August.

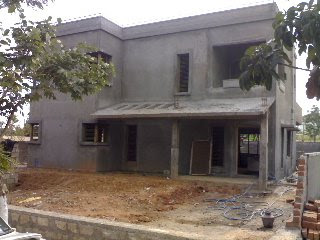

Plastering

Plastering work started in first week of June...




....and took almost 12 weeks to complete. There was 2-3 week delay due to the monsoons. By end of Aug we were preparing to finalize the floor tiles. Tiling would be the next major activity and expected to start in early September.
